Paving Project Updates for Oct. 5-11
The Vermont Agency of Transportation (VTrans) is providing weekly updates about the paving project in Brattleboro. The latest update was published on Oct. 3, 2025. Sign up for alerts here, or learn more about this project.
Parking Impacts

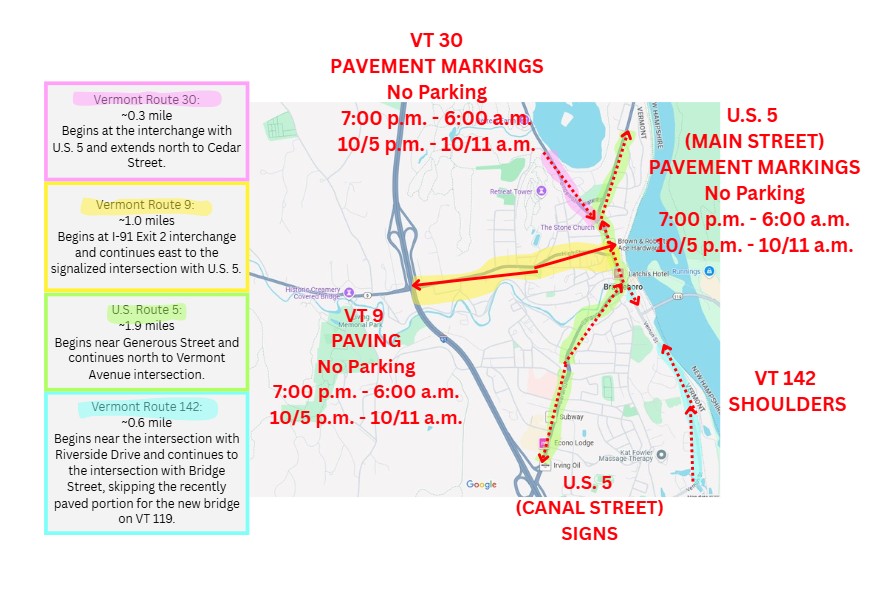

Street side parking will be unavailable and strictly enforced, particularly on Western Avenue and High Street (VT 9) and in areas throughout downtown where pavement markings are laid out but have not yet been painted. From 7 p.m. to 6 a.m. Sunday night through Saturday morning, paving and painting operations are scheduled in multiple locations throughout the project. To see alternative lots with rates and hours, please go to https://brattleboro.gov/parking.
Traffic Impacts
Brattleboro NH PC 25(6)
Nighttime single-lane closures will be in place Sunday night through Saturday morning from 7:00 p.m. to 6:00 a.m. Work will continue on Vermont Route 9 (Western Avenue and High Street), U.S. Route 5 (Main Street), and Vermont Route 30 (Linden Street). Flaggers will be present to direct one-way alternating traffic through multiple work zones. Motorists should be aware of wet paint.
Parking restrictions will be enforced during working hours. Pedestrians should watch for sidewalk detours.
Brattleboro-Putney STP PS 25(11)
Nighttime single-lane closures will be in place Sunday night through Saturday morning from 7 p.m. to 6 a.m. on U.S. 5 (Putney Road) from the intersection with Vermont Avenue to the approximate intersection with Noah's Lane. Flaggers will be present to direct one-way alternating traffic through the work zones.
Construction Activities
Crews continue to measure decibel levels with noise monitoring equipment throughout the work area.
Brattleboro NH PC 25(6)
Western Avenue and High Street (VT 9) - Sidewalks are currently under construction. Paving operations on VT 9 were re-scheduled to begin this upcoming Sunday and to continue until finished with the mainline roadway, side roads, and driveways.
Linden Street (VT 30) and Main Street (U.S. 5) - The pavement marking operations have about 2-3 shifts of work remaining in this area total which are anticipated to wrap up at the start of next week.
Vernon Street (VT 142) - Shoulder work and driveways should be completed by the end of this week and permanent pavement markings are planned for Sunday and Monday nights.
Canal Street (U.S. 5) - Paving the last few driveways should occur by the end of this week. Crews are installing new signs. Otherwise, this corridor has most major operations complete.
Brattleboro-Putney STP PS 25(11)
Milling and paving the first lift of pavement are complete on Putney Road (U.S. 5) near the intersection with Vermont Avenue to approximately the intersection with Noah's Lane. Crews will be working on utility structure adjustments through this area.
